Engineered Hardwood · NWFA-Compliant Installation Guide

Hardwood Installation Guidelines

Müller Graff engineered hardwood is aligned with NWFA (National Wood Flooring Association) standards. Read completely before beginning installation. The installer is responsible for all site conditions.

Section 01

Pre-Installation Requirements

Jobsite Conditions

ConditionRequirement
Building EnclosureWindows and doors must be fully installed
HVAC OperationalMinimum 14 days prior to delivery
Wet TradesDrywall, plaster, paint, and tile must be complete and dry
Indoor Temperature60°F – 80°F (15°C – 27°C)
Relative Humidity30% – 50% RH
Subfloor Flatness3/16" in 10' maximum variation

Installer Responsibilities

  • Carefully inspect ALL material prior to installation — do not install any defective or unwanted boards
  • Natural color and grain variation is expected; blend from multiple cartons during layout
  • Document jobsite conditions (RH, temp, moisture readings) before installation
  • Leave 5–8% extra material for cuts and grading
  • A manufacturing and grading defect allowance of up to 5% is industry standard
Section 02

Acclimation

RequirementSpecification
Duration3–5 days minimum (longer if RH >50%)
MethodStore flat in installation room with cartons open
Jobsite RH30–50% during acclimation
Temperature60°F – 80°F during acclimation
Radiant Heat: Follow stepped acclimation and reduce radiant to 65°F during acclimation period.
  • Open cartons and allow planks to breathe in the installation room
  • Document temperature and RH before and during acclimation
  • Blend planks from multiple cartons for natural appearance
  • Acclimate in garages, outdoors, or unheated spaces
  • Stack cartons closed — planks must breathe
  • Begin installation before flooring has reached EMC
Section 03

Moisture Testing & EMC

Equilibrium Moisture Content (EMC)

For engineered hardwood installation, EMC must be established by measuring jobsite temperature and relative humidity and referencing an EMC chart to determine the target moisture range; EMC is calculated by matching the ambient RH and temperature to standard EMC tables, which show the moisture content the wood will stabilize at. An acceptable EMC range for installation is typically 6–9% moisture content, which corresponds to normal interior conditions of about 30–50% relative humidity; installers must confirm the flooring has acclimated to this EMC range before installation and maintain those conditions long-term to minimize dimensional movement and prevent issues such as cupping, gapping, or delamination.

Interactive EMC Calculator

Adjust temperature & humidity to calculate expected wood EMC

70°F
30°F130°F
40%
5%95%
7.8% EMC
Ideal

Conditions are within the 6–9% installation target.

0%6–9% ideal25%

EMC Quick Reference at Standard Jobsite Conditions

Temperature30% RH40% RH50% RH
60°F5.6%7.2%8.6%
70°F6.3%7.9%9.4%
80°F6.9%8.5%10.1%

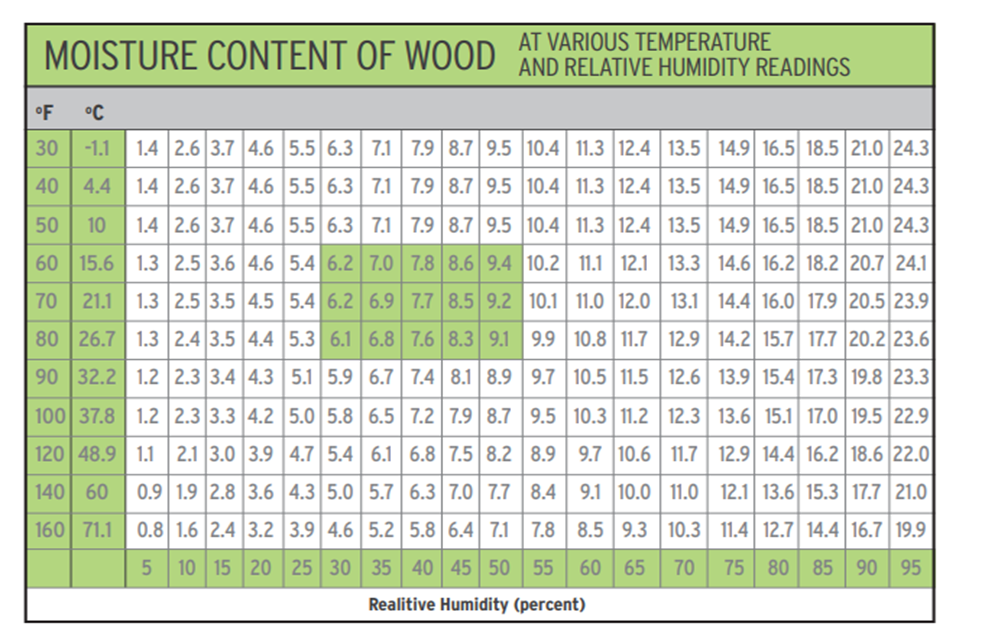

NWFA Moisture Content of Wood — Temperature & RH Reference Chart

Use this chart to determine the expected EMC of wood at your jobsite's temperature and relative humidity.

NWFA Moisture Content of Wood at Various Temperature and Relative Humidity Readings

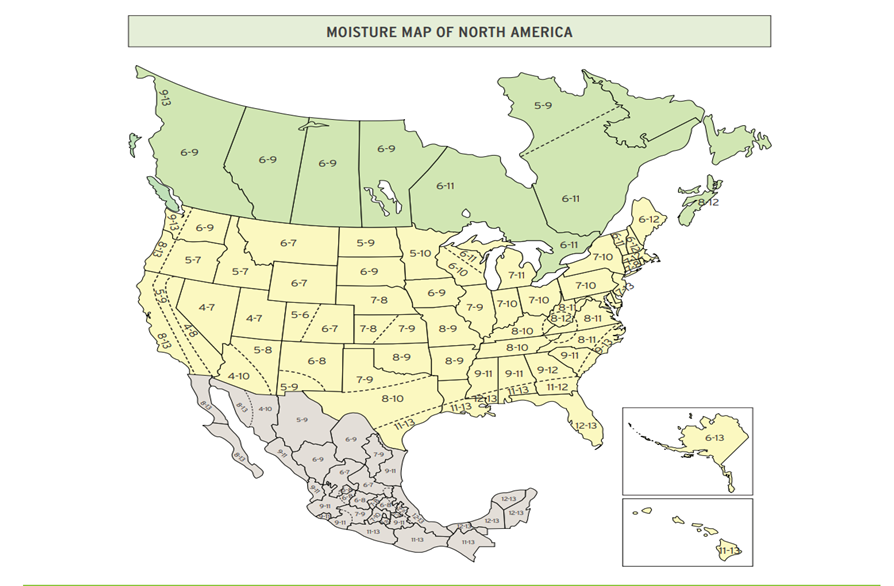

NWFA Moisture Map of North America

This map shows expected EMC ranges by region. Your region's range determines the target MC your flooring must reach during acclimation.

NWFA Moisture Map of North America

Moisture Testing Requirements

Test TypeMaximum Acceptable Value
Wood Subfloor MC≤ 12%
Flooring vs Subfloor Differential≤ 3% MC difference
ASTM F2170 (In-situ RH probe)≤ 75%
ASTM F1869 (Calcium Chloride)≤ 3 lbs / 1000 sf / 24 hr
Tramex Concrete Meter≤ 4% upper scale
Section 04

Subfloor Requirements

Subfloor TypeMin. ThicknessFlatnessNotes
Plywood5/8" CDX3/16" in 10'Exposure 1 PS1-95
OSB3/4"3/16" in 10'Exposure 1 PS1-95
ConcreteN/A3/16" in 10'Fully cured — 60+ days minimum
Solid Wood3/4" x 5.5"3/16" in 10'Group 1 dense softwoods
  • Use leveling compound with 3,000+ psi compressive strength
  • Install new floor perpendicular to existing wood subfloor boards
  • Use gypsum-based fillers in high moisture areas
Section 05

Moisture Barrier & Vapor Retarders

Wood Subfloors

Use vapor retarder with perm rating 0.7–50 (e.g., asphalt-saturated kraft paper, silicon vapor shield).

Concrete Subfloors

Use moisture barrier with perm rating < 0.13 (e.g., Titebond® 531+ or equivalent moisture-cured urethane adhesive with built-in barrier).

Section 06

Installation Methods

MethodSubstrateNotes
Glue-DownWood, ConcreteUrethane/silane adhesive; roll at 100 lbs post-install
FloatingAny flat subfloorUse underlayment + vapor retarder; 1/2" expansion gap
Nail-DownWood subfloors only18–20 gauge cleats/staples; glue-assist on widths ≥ 5"

Installation Process Overview

Step-by-step visual guide for nail-down engineered hardwood installation

STEP 01

Prepare Subfloor

Clean, flat, dry. Max 3/16" variation in 10 ft.

STEP 02

Check Moisture

Measure subfloor and flooring moisture content. Confirm acceptable levels per manufacturer and jobsite conditions.

STEP 03

Acclimate Flooring

Acclimate flooring per manufacturer guidelines. Maintain 60–80°F and 30–50% RH.

STEP 04

Lay Reference Line

Snap chalk line parallel to longest wall, square to room.

STEP 05

Install First Rows

Face-nail first 2–3 rows. Tongue faces out into room.

STEP 06

Blind Nail / Glue

Blind-nail at 45° through tongue every 8–10".

STEP 07

Maintain Expansion

Keep ½–¾" gap at all walls, pipes, and fixed objects.

STEP 08

Install Moldings

Add T-moldings at transitions. Install baseboards last.

Cross-Section: Nail-Down Assembly

Room Air — 60–80°F / 30–50% RHENGINEERED HARDWOOD FLOORING (½" – ¾")PLYWOOD SUBFLOOR (min. ¾")JOISTJOISTJOIST½–¾" GAP

Yellow zones = required expansion gap at walls. Blind-nail at 45° through tongue every 8–10".

Layout & Racking Guidelines (All Methods)

  • Remove all doors, baseboards, and shoe mouldings before installing
  • Plan layout to avoid planks narrower than 2" in the final row
  • Stagger end joints a minimum of 2x the plank width
  • Always blend from multiple cartons for color and grain consistency
  • Create H-patterns, stair-steps, or aligned end joints

Nail-Down Installation Details

  • Use 18–20 gauge cleats or staples (1½"–2") approved for engineered wood
  • Nail every 4"–6" along plank, 1"–2" from ends
  • Glue-assist required on planks 5" wide or wider
  • Face-nail the first and last rows where necessary; fill nail holes
  • Install nail-down over concrete or radiant heat unless plywood subfloor is first installed

Glue-Down Installation Details

  • Use urethane or silane-modified adhesive only
  • Trowel adhesive per manufacturer specs — cover only what can be installed within 30 minutes
  • Set planks into adhesive and roll floor with 100 lb roller
  • Maintain ½" expansion space around entire perimeter
  • Clean adhesive residue immediately
  • Wait 8–24 hours for foot traffic depending on adhesive cure time
  • Use tapping blocks — avoid striking planks directly with mallet
  • Allow 6" stagger between end joints; avoid pattern repetition

Floating Floor Details

  • Install over approved underlayment with vapor retarder
  • Glue joints with approved PVA glue (tongue and groove); strap rows and allow cure before traffic
  • Clean excess glue immediately
  • Cut door casings 1/16" higher than flooring + underlayment thickness
  • Provide expansion space around all fixed objects (fireplaces, stair stringers, stonework, outlets)
  • Anchor T-mouldings or transitions to the floating floor — anchor to subfloor only
  • Install floating floors beneath fixed cabinetry or islands
  • Place furniture or appliances over 600 lbs without providing additional expansion space
Not all Müller Graff engineered products are approved for floating installation. Verify product eligibility before proceeding.

Locking Mechanism Types

System TypeInstallation Technique
Angle / AngleTilt and lock both long sides and ends simultaneously
Angle / HookLong side angles in; end hooks secure as next row installs
Angle / Fold DownSingle-action lock (often with audible click)

Peel-and-Stick Underlayments

  • Peel film only as wide as the next plank being installed
  • Press plank firmly into exposed adhesive and continue row by row

Starter Row

  • Align first row with precision (max deviation 3/16" over 10')
  • Start the next row with the cut-off from prior row (minimum 12" length)
Section 07

Herringbone Installation Guidelines

Based on NWFA Standards for Engineered Wood Flooring — Glue-Down Patterned Layouts. Herringbone is a precision pattern that magnifies even small errors. Proper layout is critical.

Jobsite Conditions (Herringbone-Specific)

ConditionRequirement
HVAC OperationalMinimum 7 days before delivery
Temperature / RH60°F–80°F / 30%–50% RH before, during, and after
Subfloor Flatness3/16" in 10' or 1/8" in 6' — use self-leveling compound
Subfloor MC≤ 12%
Flooring MC DifferentialWithin 2–3% MC of subfloor
Concrete CureMinimum 60 days; ASTM F2170 ≤ 75%, ASTM F1869 ≤ 3 lbs, Tramex ≤ 4%

Layout Planning

  • Identify the primary visual wall or space center and snap a centerline
  • Snap a perpendicular layout line using a 3-4-5 method; confirm 90° angles with laser or framing square
  • Create a rigid starter block (plywood jig or cleated board) to maintain pattern alignment
  • Dry-lay a full section of herringbone to verify pattern fit, squareness, and room impact
  • Choose orientation: 'V-point toward main entry' or 'diagonal' based on design intent

Adhesive & Tools Required

ItemSpecification
AdhesiveMoisture-cured urethane (e.g., Bona R851, Sika T-55, Bostik GreenForce)
Trowel SizePer adhesive specs — typically 3/16" x ¼" V-notch
Roller100 lb. roller required
TapePainter's tape only — not duct or masking tape

Step-by-Step Herringbone Installation

1.

Establish First Row

Begin at centerline using a starter block to hold first 'V' pair. Confirm first few rows are square to layout lines.

2.

Apply Adhesive

Spread only what you can install in 30 minutes. Press each plank firmly into the adhesive.

3.

Install in Sections

Continue pattern row by row, keeping tight joints. Use painter's tape to hold rows in alignment while adhesive sets.

4.

Use Splines as Needed

When changing direction or when groove-to-groove boards meet, use splines (slip tongues) with adhesive.

5.

Roll Floor

Use a 100 lb. roller every 2–3 rows and once again after full installation.

6.

Expansion Gaps

Maintain ½" expansion space at all vertical surfaces.

7.

Cure Time

Avoid foot traffic for 12–24 hours, or per adhesive manufacturer's specification.

Key Considerations

  • Confirm board squareness — pre-milled herringbone boards must be precise before installation
  • Dry-lay boards from multiple cartons to blend color and grain pattern
  • Recheck alignment every 3–5 rows to prevent visual drift across the field
  • For fireplaces or built-ins, use a temporary perimeter board to finish cleanly against edges
Radiant Heat: Only install over approved radiant systems. Maximum subfloor surface temperature is 85°F.
Section 08

Radiant Heat

ConditionRequirement
Max Surface Temperature82°F (28°C) — never exceed (85°F for herringbone glue-down)
Heat-Up ProtocolGradual — increase 5°F per day after installation
Cool-Down ProtocolGradual — decrease 5°F per day
Moisture Test RequiredYes — documented before installation
Acclimation AdjustmentReduce radiant to 65°F during acclimation period
A signed heat-up and cool-down protocol must be on file. Claims related to radiant heat are excluded if not documented.
Section 09

Expansion Rules

LocationRequirement
All Walls½"–¾" expansion gap on all sides
Fixed Objects½" gap around pipes, columns, door frames, fireplaces
Large Rooms (> 40 ft)Expansion joint required
Doorways / TransitionsT-moulding at every room change — anchored to subfloor only
Section 10

Crawlspaces & Basements

RequirementSpecification
Vapor Barrier6-mil poly — 100% coverage of crawlspace floor
Clearance to Joists18" minimum
Perimeter Venting1.5% of crawlspace area for cross ventilation
Section 11

Installer Responsibilities & Final Checks

  • Inspect ALL material prior to installation — do not install defective boards
  • Document jobsite conditions (RH, temp, moisture readings) before beginning
  • Leave 5–8% extra material for cuts and waste
  • Protect floor during construction — cover with breathable material (perm rating ≥ 1)
  • Remove adhesive residue immediately after installation
  • Allow 24 hours before moving furniture back in
  • Clean floor, install all trim and transition mouldings
  • Leave touch-up kit and spare material with the owner
  • Install in bathrooms, saunas, or areas with floor drains
  • Install when RH is outside 30–50% range
  • Skip moisture testing on any subfloor type
  • Install defective boards — installation constitutes acceptance of material
  • Allow standing water during or after installation
Section 12

NWFA Jobsite Checklist Summary

Checklist ItemRequirement
HVAC operationalYes — 14+ days pre-installation
Temperature / RH maintained60°–80°F / 30–50% RH
Subfloor flatness verifiedMax 3/16" in 10'
Moisture testing documentedFlooring and subfloor MC measured and recorded
Crawlspace sealed and ventilatedYes
Vapor barrier in placeYes — wood and concrete subfloors
Material inspected before installYes — defective boards removed
Expansion gaps maintained½"–¾" at all perimeter and fixed objects

Reference: Müller Graff Hardwood Installation Guidelines | NWFA Standards. Proper installation directly supports your warranty. Maintain 60–80°F / 30–50% RH year-round to minimize seasonal movement.
